Wärtsilä completed three EPC projects to Brazil in record time and enabled customer to meet vital power supply commitment

The technology group Wärtsilä’s engineering, procurement and construction capabilities have been clearly demonstrated with three recent project deliveries to Brazil, which were successfully completed in record time. The orders were placed in Q4, 2021 by TEVISA, Linhares Geração, and Povoação Energia, companies held by funds managed by BTG Pactual Asset Management.
The urgency for completion was the result of the need to meet the required Commercial Operation Date of the power plants as set by the rules of the Reserve Capacity Auction, which was arranged by Brazil’s Ministry of Mines and Energy in October 2021. From contract signing to commencement of commercial operation, the time normally required for each project would be approximately 14 months. In this case, however, Wärtsilä completed all three projects in less than 8 months. Construction of the buildings until commissioning took just three months, and although the equipment was delivered in Q2/2022, all three plants were already in commercial operation by July 2022.
Thanks to Wärtsilä’s ability to meet the strict deadline requirements, the customer has been able to meet fully the Power Purchase Agreement requirements by the Brazilian energy authorities. The electricity produced by these power plants will be fed to the national grid, thereby assuring system reliability.

“We are extremely pleased with Wärtsilä’s efficiency and reliability in having everything completed on time, despite the exceptionally tight schedule. They overcame all the many challenges involved and, in partnership with our team, performed a first-class job. Their reputation in Brazil for being a reliable partner with outstanding EPC capabilities, is well earned,” said Marcelo Oliveira, CEO at TEVISA, Linhares Geração and Povoação Energia.
“Completing these projects within the necessary time-frame required all our experience and know-how. Our existing strong presence in Brazil and understanding of the local needs and practices was of essence in making the fast-track deliveries a success. We utilised increased manpower and extra construction equipment on the sites, and worked in two shifts seven days a week. I think we have sent another clear message to the energy sector regarding Wärtsilä’s capabilities,” commented Jorge Alcaide, Director, Americas South, Wärtsilä Energy.
Among the many difficulties encountered were shipping congestion difficulties resulting from logistic hold-ups and the Covid 19 pandemic, and the war in Ukraine which affected material availability. Wärtsilä was able to meet these challenges, for example, by specifically chartering a vessel to deliver equipment and materials, and using a significant number of air freight deliveries to ensure everything was on site when needed.

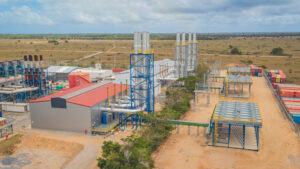

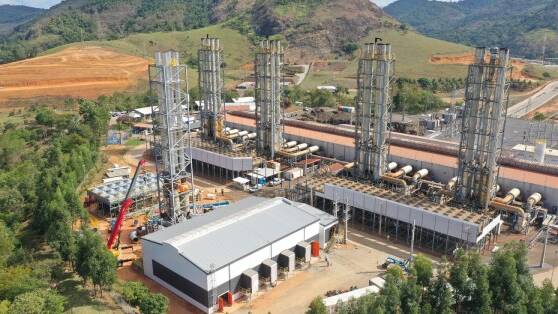

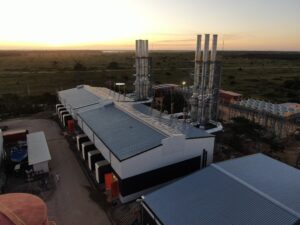

The three power plants are part of three separate projects, all in the state of Espirito. The UTE Luiz Oscar Rodrigues de Melo plant and the UTE Povoaҫӑo1 plant are both located in the city Linhares, and the UTE Viana 1 plant in the city of Viana. All three projects feature Wärtsilä 34SG gas engines, in total 16 engines with a combined output of approximately 150 MW, sufficient to provide electricity to some 280,000 households in the region.

To date, Wärtsilä’s track record of EPC deliveries comprises 551 power plants in 109 countries. Their total output is close to 21,720 MW. For each project, specific needs must be met, as well as compliance with regulations, concern for the environment, and the well-being of the local communities affected. Wärtsilä has developed a flexible approach to the varying demands, providing the customer with a single point of contact to ensure efficient project management, while making full use of the latest digital technologies and information systems.
Wärtsilä has been present in Brazil since 1990 and has operations in Rio de Janeiro and Manaus. To date, Wärtsilä has delivered 2.9 GW of power plant capacity in Brazil, of which over 700 MW are currently covered by Wärtsilä long-term service agreements. Wärtsilä has also converted 275 MW of oil-fuelled capacity in the country to run on natural gas.
Related News.
November 25, 2026
Crewing After 2026: How AI Will Take Over the Routine in 2027
The crewing market of late 2026 is not the market of 2025. Artificial intelligence has moved from presentations into daily crewing work, while the…
November 25, 2026
Dualog launches secure maritime AI service amid surge in seafarer AI use
The new service, Sparks lets crew and shore teams search company emails, documents and conversations without exposing sensitive fleet information to…
November 25, 2026
Time Ticking: Two weeks for Governments to Green-Light Framework for Cutting Shipping Emissions
As a crucial fortnight of meetings opens at the International Maritime Organization opens in London, the Clean Shipping Coalition calls on member…
November 25, 2026
“K” LINE signs contract for construction of two LPG dual-fuel VLGCs
Kawasaki Kisen Kaisha, announces today that it has signed agreements with South Korea-based HD Hyundai Samho regarding the construction of two LPG…
November 25, 2026
Equinor and VNG sign 18-year gas sales agreement for supplies to Germany
Equinor will supply natural gas to the German energy company VNG until the end of 2044. The 18-year agreement is the longest gas sales agreement…
November 25, 2026
Open letter to MEPs to reject the motion for a resolution and support the inclusion of Indian ship recycling yards on the European List
Dear Members of the European Parliament, Ahead of this week’s plenary vote, European Shipowners | ECSA, BIMCO, the Cruise Lines International…
November 25, 2026
ShipVet appoints James Stairmand as Chief Executive Officer
Founder Captain Fintan Cullen moves to a non-executive role as the company builds on investment in its vetting team and technology. ShipVet, the…
November 25, 2026
USD ≈7bn lost per year the hidden cost of how shipping trades
New Torvald Klaveness study quantifies around USD 7bn a year in potentially avoidable costs in dry bulk and product tanker shipping, with a possible…
November 25, 2026
APM Terminals Maasvlakte II and Port of Rotterdam Authority take next step in terminal development
APM Terminals Maasvlakte II and the Port of Rotterdam Authority are moving forward in terminal’s development with preparations for a new phase of…
November 25, 2026
ABP inspiring the next generation
ABP host 500 young people to explore maritime and transport careers More than 500 young people from across Hampshire and the Solent explored career…
Subscribe to our newsletter!
if you dont want to swim alone in the ocean of news, sign up for the newsletter, and you will receive daily all the important news of world shipping!
Design & Development by P.KAN.DESIGNER
© 2026 Cyprus Shipping News. All rights reserved
Design & Development by P.KAN.DESIGNER
© 2026 Cyprus Shipping News. All rights reserved
